MCC Panels

Testing and Commissioning of Panel Assemblies

Complete guide to panel testing and commissioning procedures.

Testing and Commissioning of Panel Assemblies

Testing and Commissioning of Panel Assemblies

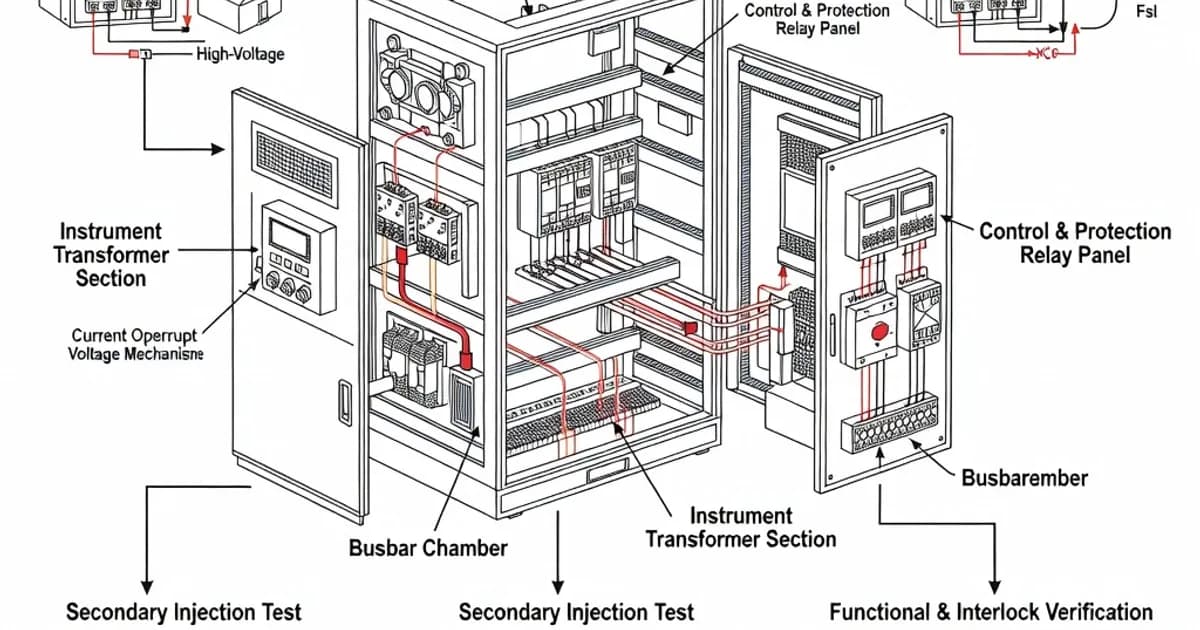

Testing and commissioning are the final technical gates before a low-voltage panel assembly is handed over for service. For IEC 61439-compliant assemblies, this work is not optional documentation activity; it is part of the verification chain that demonstrates the assembly remains safe, functional, and consistent with its verified design. IEC 61439-1 distinguishes between design verification under Clause 10 and routine verification under Clause 11. Design verification confirms that the design concept can meet the required performance. Routine verification confirms that the specific assembled panel has been built correctly and operates as intended.

In practical terms, testing and commissioning cover everything from tightening terminations and checking protective bonding to performing insulation resistance tests, functional tests, and phase rotation checks. Site commissioning then extends those checks into the installed environment, where cable routing, earthing, upstream protection settings, and source conditions must also be confirmed. As documented in the ABB workbook on IEC 61439 practice and the Siemens and Schneider commissioning procedures, this sequence is essential to prevent avoidable faults during energization and to preserve the integrity of the assembly at handover.

Why testing matters in IEC 61439 assemblies

IEC 61439 panels are safety-related assemblies, not just enclosures filled with devices. A unit may contain circuit-breakers, busbars, control wiring, metering, PLC interfaces, and interlocking functions, and every one of these elements can affect compliance. A panel that has passed design verification can still fail in service if a conductor is left loose, a protective earth path is incomplete, an IP gasket is damaged, or device settings do not match the intended coordination study. For that reason, routine tests and commissioning checks are the final opportunity to verify workmanship and site-specific correctness before energization.

Per IEC 61439-1 Clause 11, routine verification is performed on each completed assembly or on each assembly section as applicable. The intent is to confirm that the manufactured panel corresponds to the verified design and that no assembly defects compromise performance. In addition, the site commissioning process validates the installation context: supply characteristics, cable termination quality, protective device settings, and the sequence of energization.

IEC 61439 Testing Framework

The IEC 61439 series uses a structured verification model. Clause 10 covers design verification, which may be established by testing, calculation, comparison with a verified reference design, or a combination of these methods. Clause 11 covers routine verification, which must be applied to the manufactured assembly. This distinction is important: temperature rise, short-circuit withstand, and dielectric capability are design verification topics, while the builder still needs to confirm workmanship and assembly integrity on the actual unit.

IEC 61439-2 applies specifically to power switchgear and controlgear assemblies, including assemblies rated up to 6300 A. In practice, this means most distribution boards, MCCs, and power panels fall within the scope of the 61439-2 product standard. Individual devices fitted inside the assembly are additionally governed by IEC 60947 series requirements, particularly for circuit-breakers, contactors, disconnectors, and motor starters. In Europe and the UK, the harmonized EN/BS EN versions are used for conformity with applicable regulatory requirements, including the Low Voltage Directive and EMC obligations where relevant.

Design verification versus routine verification

Verification type Scope Typical evidence Applies to
Design verification Confirms the design concept meets IEC 61439 requirements Type tests, calculations, comparison with a reference design, documented ratings Representative design or configuration
Routine verification Confirms the actual assembled unit is built correctly Visual inspection, functional tests, continuity, dielectric checks, assembly records Each production assembly
Site commissioning Confirms the installed panel operates correctly in the field Point-to-point checks, phase rotation, energization sequence, settings confirmation Installed equipment at site

Routine Tests Required for Low-Voltage Panel Assemblies

IEC 61439-1 Clause 11 identifies the routine verifications that must be performed on the completed assembly. The exact execution may vary by product type and manufacturer, but the core intent is consistent: verify functionality, insulation, protective bonding, and constructional integrity. Industry guidance from ABB, Schneider Electric, and technical practice notes from engineering portals broadly align on the same sequence.

1. Functional checks

Functional checks verify the electrical and mechanical operation of all installed devices. This includes opening and closing of switches and circuit-breakers, mechanical interlocking, door interlocks, selector switch positions, indication lamps, meters, and auxiliary contacts. Devices must operate in accordance with the drawings and settings schedule. A breaker that trips correctly but has an incorrect shunt-trip wiring connection or an inverted auxiliary contact arrangement fails the intent of routine verification.

These checks should include verification of all accessible control functions, emergency stop circuits where fitted, and any electrically operated mechanisms. Where withdrawable units are used, racking functions, position indication, and mechanical interlocks should be checked through their full operating range. Siemens and ABB commissioning documents emphasize that the mechanical sequence matters as much as the electrical result because a control circuit may appear functional while a mismatch in interlocking leaves the assembly unsafe.

2. Dielectric properties and insulation testing

Dielectric verification confirms that live parts are adequately insulated from each other and from exposed conductive parts. For routine testing, the assembly is tested de-energized with no loads connected. Short-circuit-sensitive devices should be protected or disconnected as required by the manufacturer’s instructions. Practically, panel builders commonly apply insulation resistance measurements with a suitable megohmmeter and then perform a dielectric withstand test where specified by the test procedure.

Research sources note a practical insulation resistance target of at least 0.5 MΩ for typical 230/400 V assemblies, while the minimum insulation resistance criterion is often expressed as 1000 Ω/V relative to nominal voltage. For example, a 400 V assembly would require a minimum of 0.4 MΩ by that rule, although many organizations adopt a higher internal acceptance threshold for greater reliability margin. The exact test voltage and duration should follow the applicable IEC 61439 part and the manufacturer’s procedure; UL’s guidance on IEC 61439 testing also notes the use of a 1-minute dielectric withstand procedure where specified.

Good practice is to verify insulation after the assembly has been fully dressed, cleaned, and dried, but before final energization. Accumulated dust, trapped wiring scraps, moisture, or incorrect gland termination can produce misleading or failing results. If the test fails, the source of leakage should be located by sectional isolation rather than simply repeating the test.

3. Protective circuit continuity

Protective earthing and bonding are fundamental to assembly safety. IEC 61439 requires continuity of the protective circuit so that all exposed conductive parts are effectively connected to the main earth terminal or earth bar. Industry guidance commonly applies a low-resistance ohmmeter and looks for a resistance of less than 0.1 Ω between exposed metal parts and the main ground bus, subject to test lead compensation and the practical length of the circuit under test.

This check must include doors, gland plates, cable support plates, withdrawable carriers where applicable, sub-assemblies, and any removable conductive section that could become dangerous if disconnected. Earthing faults are often caused not by an obvious open circuit but by poor mechanical contact, paint under lugs, missing serrated washers, loose bonding straps, or unbonded accessories. ABB’s IEC 61439 guidance places strong emphasis on the continuity of the protective circuit because this is one of the most important routine verifications for safe operation.

4. Degree of protection and enclosure integrity

The enclosure’s degree of protection, expressed as an IP code under IEC 60529, should be visually checked during routine verification and again during commissioning after cable entry and accessory installation. In many cases, the IP performance of the empty enclosure or factory-assembled section is established by design verification, but site work can compromise that protection. Missing blanks, poorly fitted gland plates, damaged seals, or incorrectly torqued cover fasteners can reduce the actual protection level significantly.

For assemblies installed in harsh environments, such as utility substations, process plants, or outdoor service areas, this check becomes especially important. A panel may remain electrically correct while failing to resist ingress of dust, moisture, or conductive contamination. Control-panels.org and manufacturer manuals consistently treat enclosure integrity as a commissioning-critical item, not merely a cosmetic one.

5. Clearances, creepage distances, and mounting arrangement

IEC 61439-1 Clause 10 establishes the design requirements for clearances and creepage distances, and routine verification should confirm that the as-built arrangement still conforms to the verified design. This includes checking that busbars, terminals, cable lugs, and auxiliary wiring remain properly separated, that insulating barriers are present where required, and that no field modification has compromised spacing.

Mounting integrity also matters. Devices must be fastened securely, busbar supports must be correctly installed, and terminals must be tightened to the manufacturer’s specified torque. A panel can pass functional testing and still fail operationally if a busbar support is omitted or a partially tightened conductor heats under load. Schneider Electric’s LV commissioning guidance and ABB’s practice notes both stress torque verification as a recurring source of defect prevention.

Site Commissioning Procedure

Commissioning is broader than routine testing. It is the controlled transition from a verified assembly to an energized operational system. The process typically begins with a formal pre-commissioning inspection and ends only after the panel has been progressively energized, load-tested where appropriate, and its settings validated against the design documentation.

Pre-commissioning inspection

Before any electrical test, the assembly should be inspected mechanically and visually. This inspection typically covers identification labels, circuit references, wire markers, torque witness marks, cleanliness, terminal condition, shipping restraints, correct installation of removable parts, and conformity to the latest as-built drawings. Any temporary transit supports or packing materials must be removed. If the panel has been transported in sections, all interconnection hardware should be verified against the assembly schedule.

At this stage, it is also prudent to verify that all protection settings, control relays, and metering multipliers are consistent with the approved documentation. Commissioning errors often occur because the installed settings do not match the latest coordination study or because a device was factory-set for a different operating profile.

Point-to-point wiring verification

Point-to-point checks confirm that each terminal connection corresponds to the wiring diagram. This is especially important for control circuits, interlocks, CT/VT secondary circuits, emergency stop chains, and communication wiring. A single transposed conductor can prevent correct device operation or create false indications at the HMI or SCADA level.

For panels with extensive field wiring, a structured continuity check from source to destination is essential. Many commissioning procedures include sign-off sheets for each circuit group so that missing terminations, mixed conductors, and unintentional bridges are captured before energization. The procedure is straightforward but highly effective, and it is a common feature of professional method statements used by major LV equipment manufacturers.

Phase rotation and supply verification

Before closing onto the incoming supply, the phase sequence should be verified as L1-L2-L3 or the site-defined equivalent. Incorrect phase rotation can damage rotating machinery, reverse motors, and cause control logic to behave unpredictably. Voltage magnitude should also be checked at the incomer and at key downstream points, with the typical aim of confirming supply within about ±10% of nominal unless the project specification states otherwise.

For multi-source or generator-backed systems, commissioning should also confirm synchronization logic, transfer interlocking, and source prioritization. Progressive energization should proceed from the incomer through selected outgoing feeders, not by applying full load immediately. This staged approach allows abnormal heating, nuisance tripping, incorrect phasing, or hidden wiring errors to be detected safely.

Setting adjustment and final functional demonstration

After the panel is energized, final settings can be confirmed and adjusted in line with the approved coordination study. This may include overload relays, protective trip units, time delays, undervoltage releases, metering scaling, and PLC logic. The assembly should then be demonstrated through a controlled operating sequence that proves the system responds correctly to normal and abnormal commands.

Final commissioning should include a record of which circuits were energized, which tests were performed, what measured values were obtained, and which settings were applied. This record becomes the baseline for maintenance, troubleshooting, and future modifications.

Specification and Acceptance Checklist

The following table summarizes typical acceptance points used during routine testing and commissioning of IEC 61439 assemblies. The exact limits should always be checked against the approved design documentation, manufacturer instructions, and the project specification.

Test item Typical acceptance criterion Reference basis
Functional operation All devices operate according to drawings and sequences IEC 61439-1 Clause 11; IEC 60947 device instructions
Insulation resistance Common practice target ≥ 0.5 MΩ; minimum often 1000 Ω/V relative to nominal voltage IEC 61439 routine verification practice
Protective circuit continuity Typically < 0.1 Ω between exposed metal parts and main earth bus IEC 61439 protective bonding verification
Clearance and creepage Matches verified design and rated insulation level IEC 61439-1 Clause 10
IP integrity Seals, gland plates, blanks, and covers correctly installed IEC 60529; site inspection
Phase rotation Correct phase sequence at incomer and outgoing circuits Commissioning best practice
Voltage at energization Within project tolerance, commonly ±10% of nominal Project specification and commissioning procedure

Common Manufacturer Practices and Product Examples

Major panel and switchgear manufacturers provide assembly-specific commissioning guidance because IEC 61439 compliance is not achieved by a generic test sheet alone. ABB, Siemens, Schneider Electric, Eaton, and Rittal each publish product or application documentation that details torque checks, continuity verification, and routine functional testing for their systems. These documents are valuable because they translate the standard into practical site actions.

For example, ABB’s IEC 61439 workbook highlights routine verification and earthing continuity as core requirements. Siemens commissioning material for systems such as NXPLUS C emphasizes dielectric withstand, continuity checks, and progressive energization. Schneider Electric’s LV commissioning method statements typically include torque table use, dielectric testing, and trip/close functional verification. In each case, the manufacturer’s own instructions should be treated as the controlling implementation detail, especially where the assembly includes proprietary interlocks, withdrawable mechanisms, or special busbar arrangements.

Common Errors and How to Avoid Them

Many commissioning failures are simple workmanship or documentation errors rather than fundamental design defects. The most common issues include loose terminals, missing bonding straps, incorrect breaker settings, incomplete point-to-point checks, damaged seals, and unverified phase rotation. Another frequent problem is assuming that a factory-assembled line-up needs no site verification. Transport, installation, and field wiring can all alter the condition of the equipment.

To reduce risk, commissioning teams should use a controlled checklist, calibrated test instruments, and signed test sheets. Torque tools should be calibrated and traceable. Protective devices should be checked against the current single-line diagram and settings schedule. If the assembly contains sections or forms that were modified after factory testing, the modified areas should be re-verified before energization.

One practical rule is to progress from least intrusive to most intrusive verification: visual inspection, mechanical checks, continuity testing, insulation testing, low-power energization, then full functional demonstration. This reduces the likelihood of energizing a system with a hidden defect and makes fault isolation simpler if a problem is found.

Documentation and Handover

Commissioning is incomplete without documentation. The handover pack should include the as-built drawings, test reports, torque records, settings schedules, serial numbers of installed devices, calibration details for test equipment, and any nonconformance reports or corrective actions. For safety-critical installations, retaining this evidence is essential because it shows that the panel was not only built to an accepted design, but also checked and energized under controlled conditions.

Where third-party certification or client witnessing is required, the formal record should show who performed each test, when it was performed, and what the outcome was. This is particularly important for global supply chains and multi-site projects, where the same panel design may be replicated across several installations but commissioned under different site conditions.

Best-Practice Commissioning Sequence

A disciplined sequence improves both safety and efficiency. A typical workflow is: confirm documentation, inspect the enclosure and wiring, verify tightening and bonding, perform continuity tests, carry out insulation checks, confirm phase rotation and supply quality, energize the incomer, test control and indication circuits, check protective settings, and then progressively load the outgoing feeders. This sequence is consistent with industry guidance and reflects the logic used in manufacturer method statements and technical practice

Related Standards

Frequently Asked Questions

Before energizing an IEC 61439 panel assembly, the core routine verification tests should confirm workmanship, safety, and correct wiring. Typical checks include visual inspection against drawings, protective conductor continuity, insulation resistance, dielectric withstand where applicable, polarity, functional operation of devices, and verification of clearances, creepage, and labels. IEC 61439-1 requires routine verification by the assembler to ensure the assembly complies with the design and safety requirements, while IEC 60364-6 is often used as a reference for installation inspection and testing. In practice, panel builders also confirm torque settings on terminals and busbar joints, phase rotation, interlocks, control circuit logic, and correct settings on devices such as Schneider Electric Compact NSX/Masterpact, ABB Tmax, or Siemens 3VA breakers. The objective is not just to pass a checklist but to prove the completed assembly is electrically sound and ready for safe energization.
Insulation resistance testing on switchboards and MCC panels is usually performed with a suitable megohmmeter after verifying that all sensitive electronics, surge protection devices, metering, PLCs, and VFDs are isolated or disconnected as required by the equipment manufacturer. The test is commonly applied between live conductors and earth, and between phases, using a test voltage appropriate to the circuit rating and component limitations. IEC 60364-6 provides the general testing framework for installations, while IEC 61439 requires the assembly to be verified as safe and fit for service. For low-voltage assemblies, 500 V DC is commonly used for many control and distribution circuits, but the exact test level must match device ratings and manufacturer instructions. Values should be recorded and compared against acceptance criteria set by project specifications, utility requirements, or the panel builder’s quality plan. Any unexpectedly low result can indicate damaged insulation, contamination, loose terminations, or moisture ingress.
Under IEC 61439, type verification and routine verification serve different purposes. Type verification demonstrates that a design can meet performance requirements such as temperature rise, short-circuit withstand strength, dielectric properties, clearances, creepage distances, and mechanical operation. This is often established through testing, comparison with a verified reference design, or calculation. Routine verification, by contrast, is the set of checks performed on every individual panel assembly before delivery and energization. It includes confirming wiring, protective conductor continuity, functional operation, visual inspection, insulation resistance, and proper installation of components. In simple terms, type verification proves the design is capable; routine verification proves the actual built panel matches that proven design. For panel builders using products such as Schneider PrismaSeT, ABB System pro E power, or Siemens Sivacon, the final assembly still needs routine verification even if a standardized, pre-verified system is used. Both are essential for compliance and safe commissioning.
Commissioning an MCC with motor starters and VFDs begins with a strict safety sequence: lockout/tagout, verify isolation, inspect terminations, and confirm the control philosophy against the wiring diagrams and cause-and-effect schedule. Start by checking auxiliary circuits, E-stops, interlocks, overload settings, and motor nameplate data. For direct-on-line or star-delta starters, verify contactor operation, phase sequence, overload trip class, and feedback signals. For VFDs such as ABB ACS580, Schneider Altivar, or Siemens SINAMICS G120, confirm parameterization, motor data entry, acceleration/deceleration times, control source, and communications links before motor runs. IEC 61439 governs the assembly, while IEC 60204-1 is often used where machinery control functions are involved. A controlled no-load test and bump test should be used first, followed by monitored live runs. Measure current, voltage, harmonics where relevant, temperature rise, and ensure the MCC ventilation and short-circuit ratings are not exceeded.
Functional testing of panel controls and interlocks should confirm that every command, indication, and permissive operates exactly as intended under both normal and fault conditions. This includes local/remote selectors, start/stop pushbuttons, emergency stops, door interlocks, breaker interlocks, ATS logic, alarm lamps, meters, and SCADA signals. The test should follow the electrical schematics, PLC I/O list, and sequence of operations, with each input and output forced or simulated where appropriate. For example, a Schneider Masterpact or ABB Emax breaker may require verification of trip unit settings, auxiliary contacts, and mechanical interlocking. IEC 61439 requires routine verification of the assembly’s function, while IEC 60204-1 and IEC 60947-5-1 are often relevant for control circuits, switching devices, and interlocking arrangements. The key commissioning rule is to test one function at a time, document the result, and confirm the system fails safe if a signal is lost, a device trips, or an emergency stop is pressed.
Thermographic inspection is best performed after the panel has been energized and placed under representative load, because temperature-related defects are only visible when current is flowing. A thermal scan can identify loose terminations, overloaded feeders, phase imbalance, poor busbar joints, or failing components such as contactors, MCCBs, or fuses. It is typically carried out during initial commissioning stability checks, after a short period of operation, and again after the load profile has normalized. For critical assemblies, a follow-up scan after several days or weeks of service is good practice. IEC 61439 does not prescribe thermography as a mandatory routine verification step, but it is widely used as part of quality assurance and preventive maintenance for low-voltage switchgear. Record the ambient temperature, load current, emissivity settings, and thermal images for traceability. Compare hotspots against adjacent phases and manufacturer temperature-rise limits, especially for products such as Schneider Acti9, ABB Tmax XT, or Siemens 3VA devices. Any abnormal temperature rise should trigger corrective action before handover.
A proper handover package for panel testing and commissioning should include the signed routine verification report, test certificates, as-built drawings, wiring diagrams, general arrangement drawings, torque records, insulation resistance results, functional test sheets, and any calibration or relay-setting files. For protection devices, include secondary injection or trip test records where applicable, plus settings for electronic trip units, protective relays, and meters. IEC 61439 expects the assembler to demonstrate compliance with the verified design, and the documentation should provide traceability from component selection to final test results. If the assembly includes products like Schneider Micrologic, ABB Ekip, or Siemens ETU trip units, save the configuration printouts and firmware details. Commissioning dossiers should also contain asset tags, spare parts lists, certificates of conformity, and a nonconformance log showing any issues and their closeout. Good documentation reduces disputes, supports future maintenance, and proves the panel was tested in accordance with the project specification and applicable standards before energization.
Panel commissioning failures are commonly caused by wiring errors, loose terminations, incorrect component ratings, missing auxiliaries, wrong device settings, damaged insulation, or incomplete factory testing. In many cases, failures are avoidable with disciplined verification against the approved drawings and bill of materials. A panel may also fail because the short-circuit rating was not coordinated with the upstream protection, ventilation was inadequate, or control logic did not match the client’s sequence of operations. IEC 61439 places responsibility on the panel assembler to ensure the delivered assembly matches the verified design, while IEC 60364-6 supports systematic inspection and testing of the installation. Prevention starts with quality control at build stage: torque marking, point-to-point checks, pre-energization continuity tests, and device setting reviews. Using standardized systems such as Schneider PrismaSeT, ABB MNS, or Siemens Sivacon helps reduce errors, but they do not replace final routine verification. Strong commissioning discipline and traceable test records are the best safeguards against avoidable failures.
